BPI Hardware Selection/Software Selection (Package Software) - Examples
The following are examples of scoring schemes that can be used in HW/SW Selection.
Aspect: SOP - Reports
|
Importance Weighting
|
Package A
|
Package B
| |||
Detailed Question
|
Compliance
|
Score
|
Compliance
| |||
Can the report writer access all databases simultaneously?
|
20
|
50
|
10
|
100
|
20
| |
Can the report writer calculate column & row totals and subtotals?
|
30
|
100
|
30
|
100
|
30
| |
Can the report writer use exponential functions?
|
10
|
50
|
5
|
50
|
5
| |
Can the report writer be used simply by an end user?
|
40
|
100
|
40
|
50
|
20
| |
Total Score for aspect
|
100
|
85
|
75
|
Aspect: Sales Order Processing
|
Importance Weighting
|
Package A
|
Package B
| |||
Sub-Aspect
|
Compliance
|
Score
|
Compliance
| |||
Master File
|
25
|
62
|
16
|
57
|
14
| |
Transactions
|
25
|
71
|
18
|
95
|
24
| |
Enquiries
|
30
|
83
|
25
|
91
|
27
| |
Reports
|
20
|
85
|
17
|
75
|
15
| |
Total Score for Aspect
|
100
|
76
|
80
|

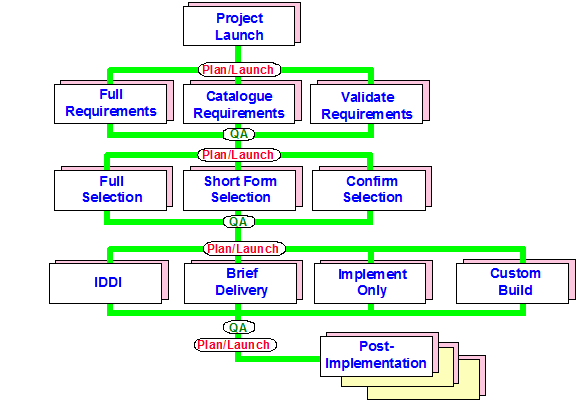

The project planning schedule gives the BPI practitioner a detail list of the steps for HW/SW selection. It should be noted that the time frames are only estimates and all steps are not required.
This plan shows a breakdown of the "Full" Requirements and "Full" Selection paths at process level. There are many optional processes in these segments and it is important to note that no one would want to include all the options shown here. The total elapsed time in this illustration is 17 months! This is what happens if you want all the options.
The paths included are:
The paths included are:
- Project Launch
- Segment Launch
- Full Requirements
- QA - Requirements
- Review path plan - post-requirements
- Segment Launch - Selection
- Full Selection
- QA - selection
- Review path plan - post-selection
This assumes that the current plan will be directly followed by a Delivery Segment. Alternatively, it might be the end of External Consultants involvement and the "Terminate Project" path could be used instead.
The tasks, duration and dependencies shown are only for illustrative purposes - you will need to translate them into a real plan based upon actual circumstances for any real project. Staffing needs are not shown at all on the illustration. The illustrative plan will be developed further and further examples will be collected.
The tasks, duration and dependencies shown are only for illustrative purposes - you will need to translate them into a real plan based upon actual circumstances for any real project. Staffing needs are not shown at all on the illustration. The illustrative plan will be developed further and further examples will be collected.
Templates/Tools
Application Comparison Worksheet
Collates information from each vendor about the proposed applications. Holds basic summary information such as release date and number of installations.
Hardware Comparison Worksheet
Collates information from each vendor about the proposed hardware configuration and operating environment. This example assumes the hardware is to be procured for the new system. A similar format could be used to collect facts relating to the degree of expected usage of an existing hardware configuration.
Hardware Comparison Worksheet
Collates information from each vendor about the proposed hardware configuration and operating environment. This example assumes the hardware is to be procured for the new system. A similar format could be used to collect facts relating to the degree of expected usage of an existing hardware configuration.
Vendor Comparison Worksheet
Collates basic information from each vendor about their organization, references, technical support capabilities and technology infrastructure etc. It gives a feel for the reliability of the vendor as a future business partner.
Cost Comparison Worksheet
Collates responses from each vendor about the expected costs for each alternative over five years.
Cost Summary Chart
Summarizes and charts the estimated cost responses from the Cost Comparison Worksheet
Cost Summary Chart
Summarizes and charts the estimated cost responses from the Cost Comparison Worksheet
System Requirements Worksheet
Contains detailed requirements from the Requirements Matrices plus columns for scores, modification costs, cross reference and textual comments for explanations etc. Can be used in one of two ways:
- As a self-assessment response form to be included in the ITT to collect responses from each vendor about how well a proposed system meets the client organizationÕs specific requirements.
- For the evaluation team to collect and collate assessments, scores, modification costs and comments relating to the responses.
System Scoring Worksheet
Collect scores for each vendor’s response about how well a proposed system meets the client's specific requirements
Scoring spreadsheet
Example spreadsheet for calculating weighted scores from compliance scores and weights, for producing summary charts and for producing layers of sub-totaling.
SQ/VQ Charts
Various example summary and detailed charts of the system quality and vendor quality findings.
